Perc Tests & Septic Systems in NC: What Land Buyers Must Know Before Closing (2026)

What NC land buyers must know before closing: how soil evaluations (perc tests) work, real septic costs, the three permits, and the $25K mistake to avoid.

The quick answer: if the land you're buying in North Carolina doesn't have sewer access, do not close until the soil has been evaluated for a septic system. A conventional septic system in the Triad runs about $5,000–$10,000. If the soil fails to support one, an engineered system runs $15,000–$25,000 — and in rare cases the lot can't support a home at all. Ten minutes of due diligence before closing protects you from the most expensive surprise in land buying.

At Triad Core Builders, we do a free site evaluation on every build-on-your-land project in Guilford, Randolph, Davidson, and Forsyth counties — and septic is the first thing we check on any rural lot. Here's everything we look at, with real numbers.

the three NC septic permits: improvement permit, construction authorization, and operation permit

"Perc test" — what NC actually does (it's better)

Everyone in North Carolina still says "perc test," and we use the phrase ourselves. But here's something most land listings won't tell you: North Carolina abandoned percolation tests years ago.

A traditional perc test poured water into a hole and timed how fast it drained. The problem: it measured what the soil did on one day, in one kind of weather. A dry July afternoon and a wet March morning could give the same lot opposite results.

What NC uses instead is a soil morphology evaluation. A licensed evaluator digs test pits across the proposed system area and reads the soil profile itself — texture, structure, color, and depth to rock or hardpan. Soil color alone reveals seasonal wetness that a one-day water test would completely miss. The result classifies your soil into Group I (sandy, well-drained) through Group IV (dense clay) — a permanent characteristic of the land, not a snapshot of the weather.

soil profile test pit showing red clay layers evaluated for a septic system

A soil profile like the evaluator sees it — deep red clay, measured horizon by horizon. Photo: USDA NRCS (public domain).

Why this matters to you as a buyer: the soil group determines what kind of septic system the lot needs, and that single fact can swing your budget by $20,000.

What the Piedmont's red clay means for your lot

Our region sits in North Carolina's Piedmont, famous for its red clay. Clay drains slowly — which means septic drain fields here need to be sized generously, and some sites need more than a conventional gravity system.

The good news: a soil evaluation almost never comes back "unbuildable." Even Group III and IV soils can usually support some system type — it's a question of which one, and what it costs:

System typeTypical cost (NC, 2026)When it's needed
Conventional gravity$5,000 – $10,000Good soil (Group I–II), adequate space
Low-pressure pipe (LPP)$6,500 – $8,000Marginal soils — common in the Piedmont
Engineered (mound, drip, advanced)$15,000 – $25,000+Poor soils, high water table, tight sites

These are the same numbers we use in our cost-to-build guide — our typical 1,800 sq ft budget carries $18,000 for a conventional well-and-septic setup, and an engineered septic system can add $10,000–$15,000 over conventional. Nothing about a "failed" evaluation kills a project by itself; it just changes the budget, and you want to know that before the land is yours, not after.

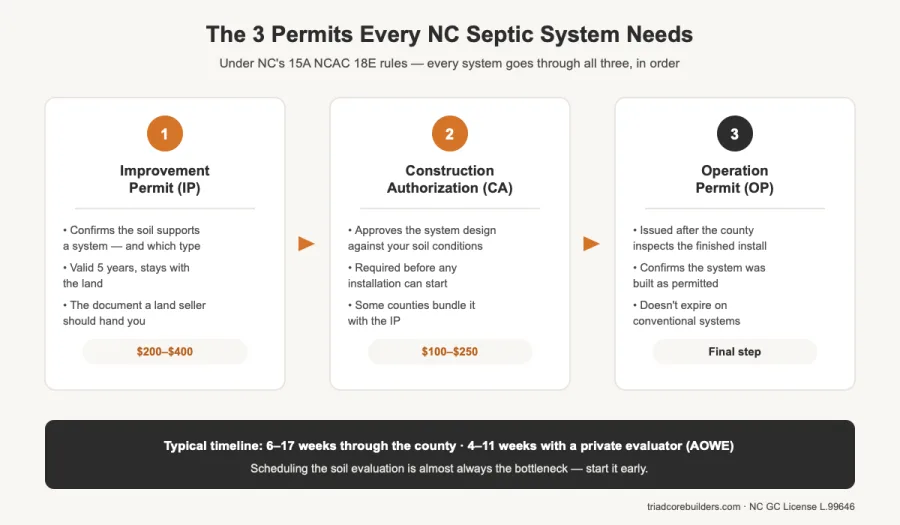

The three permits every NC septic system needs

North Carolina runs on-site wastewater through a three-permit sequence under the state's 15A NCAC 18E rules (overhauled January 2024 — the biggest update in three decades). Every system goes through all three, in order:

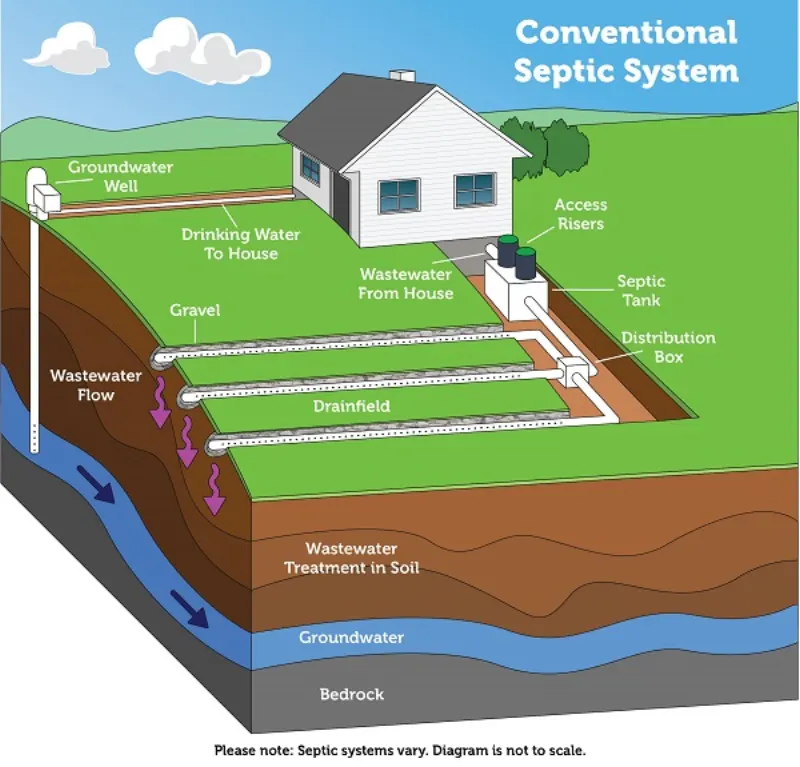

diagram of a conventional septic system with tank and drainfield

A conventional septic system: house to tank to drainfield. Diagram: U.S. EPA (public domain).

1. Improvement Permit (IP). The starting point — it confirms the soil can support a system and specifies what type. This is the document that comes out of the soil evaluation. An IP is valid for 5 years and stays with the land.

2. Construction Authorization (CA). The actual build permit. System design — tank size, drain field layout — gets reviewed against the soil conditions in the IP. No installation can legally start without it.

3. Operation Permit (OP). Issued after the county inspects the finished installation. For conventional systems it doesn't expire.

For land buyers, the Improvement Permit is gold. A seller who can hand you a current IP has already answered the biggest question about the lot. No IP? Then the burden — and the risk — is on you to get the soil evaluated before you commit. It's fair to make your offer contingent on a satisfactory soil evaluation; sellers of legitimate buildable lots rarely object.

What it costs and how long it takes

Realistic numbers for the evaluation-and-permit side (the system installation itself is the table above):

ItemTypical costNotes
County soil evaluation + Improvement Permit$200 – $400Through your county health department
Private evaluator (AOWE)$300 – $800Optional — skips the county queue, saves weeks
Construction Authorization$100 – $250Some counties bundle with the IP
Engineering design (complex sites only)$200 – $2,500+Steep slopes, poor soil, tight lots

Timeline is the part that surprises people: from first application to a finished, permitted system typically runs 6–17 weeks through the county, or 4–11 weeks using a private evaluator. The bottleneck is almost always scheduling the soil evaluation — busy counties can be backed up several weeks. This is why we start the septic conversation at the site-evaluation stage, before plans are even drawn: it keeps the permit clock running in parallel instead of holding up construction.

One more planning detail: NC sizes septic systems at 120 gallons per day per bedroom. A 3-bedroom home needs 360 GPD of capacity; a 4th bedroom pushes it to 480. If you think you might add bedrooms later, size the system for them now — upsizing afterward means going back through permitting.

new construction home built on owner's land in Greensboro NC

The five septic mistakes that cost land buyers real money

1. Closing without a soil evaluation. The big one. If the lot has no sewer and no Improvement Permit, an evaluation is the cheapest insurance you'll ever buy — a few hundred dollars against a five-figure surprise.

2. Building over the repair area. Every Improvement Permit designates a repair area — ground reserved for a replacement drain field decades from now. Pouring a driveway, shed, or pool over it is a classic mistake: when the original field eventually wears out, there's nowhere legal to put its replacement.

3. Assuming a small lot can hold a system. Setbacks from wells, property lines, and streams all constrain where a drain field can go. A lot can have fine soil and still fail on geometry. This is part of what we check in a site evaluation.

4. Counting bedrooms wrong. That "office" you plan to convert someday is a bedroom in the county's eyes. Permit capacity follows bedroom count — get it right up front.

5. Hiring an uncertified installer. Every septic installer in NC must be certified by the state's On-Site Wastewater Board (NCOWCICB), and homeowner self-installs aren't legal. An unpermitted system will surface at resale — usually at the worst possible moment.

City lot instead? Different math

On lots served by municipal utilities in Greensboro, High Point, or Winston-Salem, the whole septic question disappears — replaced by water and sewer tap and connection fees. Those are usually cheaper than a well-and-septic setup, but they vary by city and by how far the mains run from your lot. Before we quote a city-lot build, we confirm both with the city — "sewer nearby" and "sewer available to your parcel" are not always the same thing.

Frequently asked questions

How much does a perc test (soil evaluation) cost in NC?

Through your county health department, the soil evaluation is included in the Improvement Permit application — typically $200–$400 total. A private Authorized On-Site Wastewater Evaluator (AOWE) runs $300–$800 and can save several weeks of waiting.

How much does a septic system cost in North Carolina?

About $5,000–$10,000 for a conventional system in the Triad. Marginal soils that need a low-pressure pipe system run $6,500–$8,000, and engineered systems (mound, drip, advanced treatment) run $15,000–$25,000 or more.

What happens if land fails the soil evaluation?

Lots rarely "fail" outright — the evaluation determines which system types the soil supports. Poor soils usually mean a more expensive engineered system rather than no system. Truly unbuildable lots exist but are the exception, which is exactly why you evaluate before you close.

How long is an NC Improvement Permit good for?

Five years from issuance, and it can be renewed if site conditions haven't changed. A current IP transfers with the land — for buyers, it's the single most valuable document a land seller can provide.

Can I install my own septic system in NC?

No. North Carolina requires all septic installation, modification, and repair work to be done by state-certified contractors. Unpermitted work creates liability and will surface during a future sale.
